Notices
  • Weekly Cranes Operating Hrs308/
  • Cranes Uptime99.9%/
  • Cranes Downtime0.1%/
  • MTR12 mins/
  • MTBF154 hrs/
  • MMBF4306 moves/

Projects

Capital renewal across six berths

A rolling program of reconditioning, infrastructure and new equipment delivery, sequenced around vessel windows to protect berth availability.

In Progress

In Progress projects

2024 – 2030 (ESTIMATED)

Cranes 5-9 & 11-16 Corrosion Control Program

Corrosion Removal, Structural and Welding Repairs of Cranes 5-9 & 11-16, in order to address the defficiencies that resulted from Consultant Inspection Reports.

Progress37%
SEP 2026 – JUN 2027

Cranes 4 & 10 Decommisioning and Disposal

Engineered Dismantle and Disposal of PortMiami's STS Cranes 4 and 10.

Progress5%
AUG 2026 – MAR 2027

IFS Ultimo Implementation

Full implementation of this Asset Management Software, which will improve the Maintenance, Scheduling, Procurement, HSE and Warehouse management workflows.

Progress10%
MAY 2026 – FEB 2027

Cranes 11-16 New Spreaders Procurement

Procurement of three (3) new Spreaders for Cranes 11-16 to be delivered by February 2027.

Progress40%

Upcoming

Upcoming projects

2026 – 2036

Cranes 7-9 & 11-16 Mechanical & Electrical Refurbish

Short, Mid and Long Term plan refurbishment of Cranes 7-9 and 11-16, which will include the replacement and repairs of the cranes wheel brake systems, trolley brakes system, boom ropes, festoon drives, PLC upgrades, MV cables, Operator cabs, among other refurbishments.

Progress5%
2026 – APR 2028

Cranes 5-9 & 11-16 New Spreaders Procurement

Procurement of six (6) new Spreaders for Cranes 11-16 to be delivered by October 2027, with the option of three (3) more for Cranes 5-9 to be delivered by April 2028.

Progress0%

Completed

Completed projects

Sep 2025 – Oct 2025

Crane 9 Relocation

Relocation of Crane 9 from Wharf II to Wharf V through the means of Barge Transportation. This move increased the use of Crane 9 and the efficacy of Cranes 7 and 8.

Progress100%

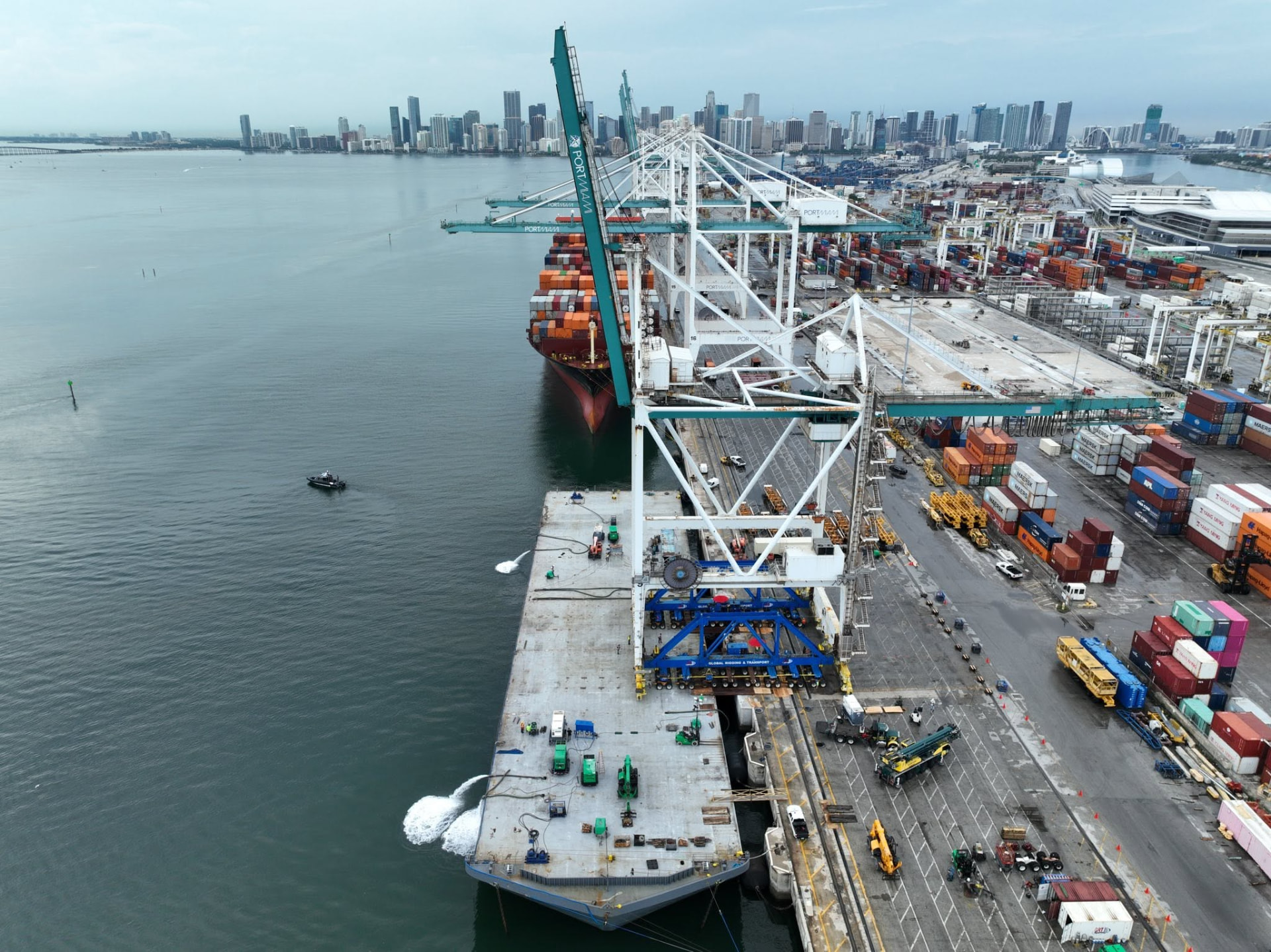

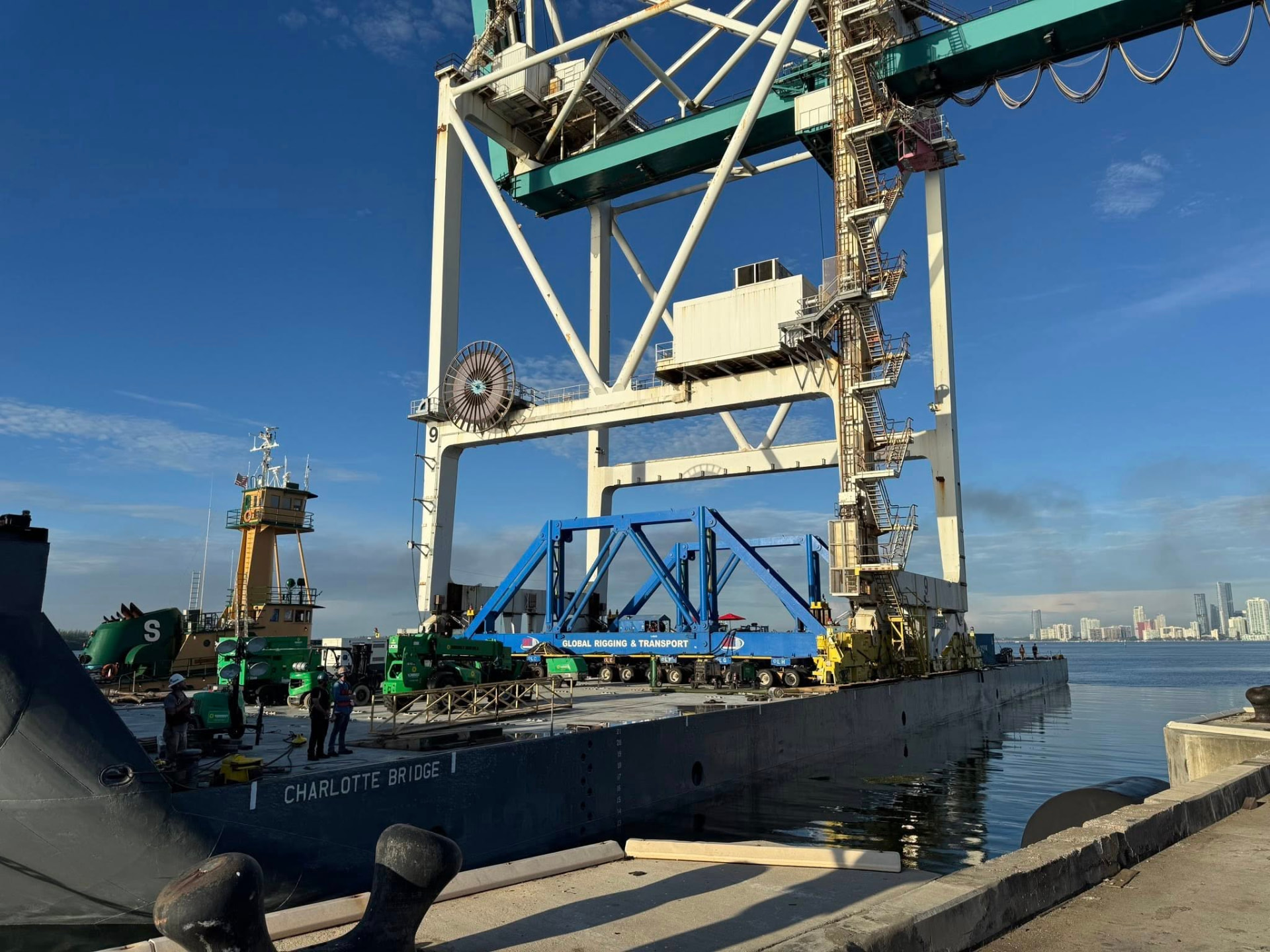

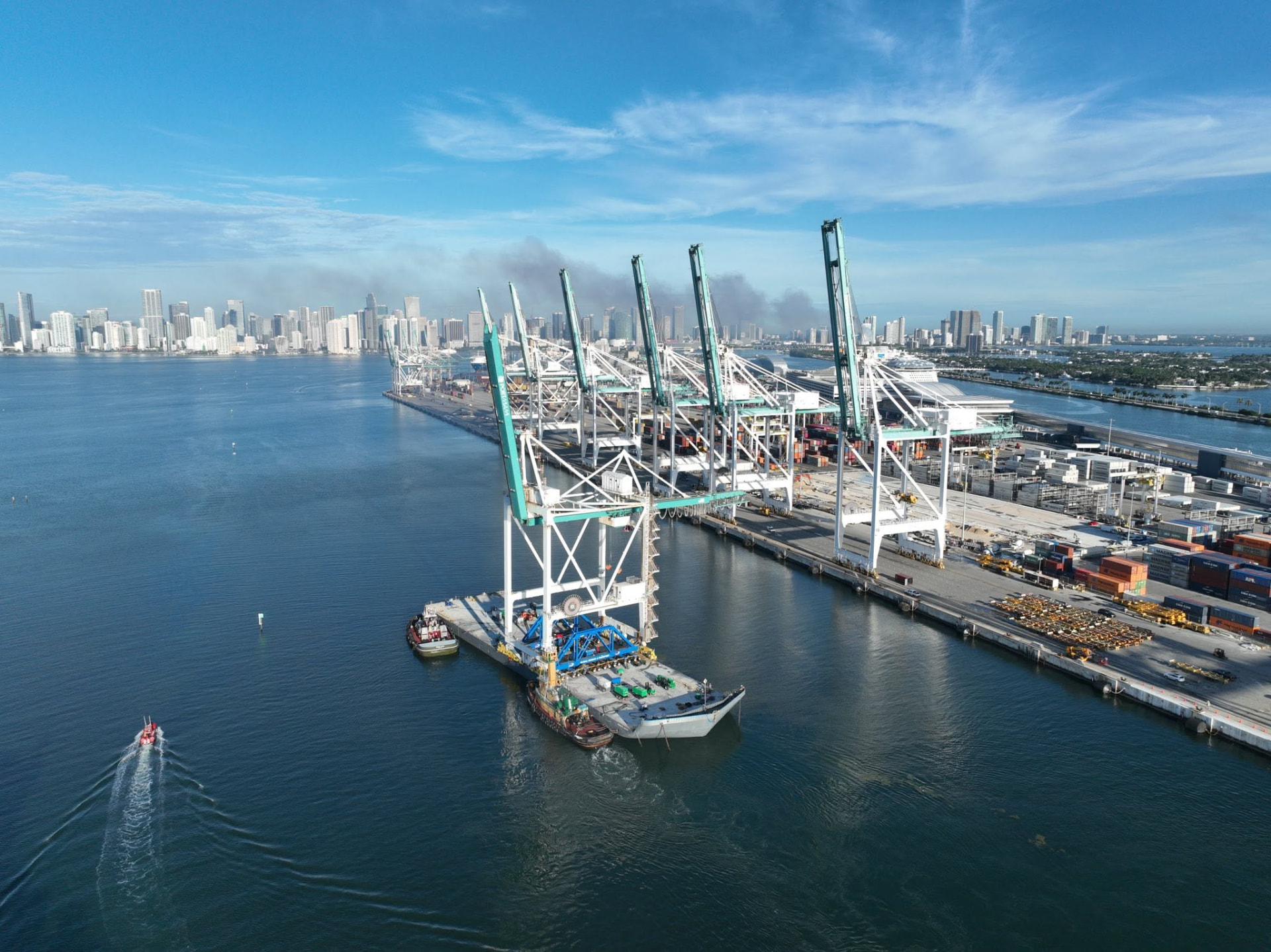

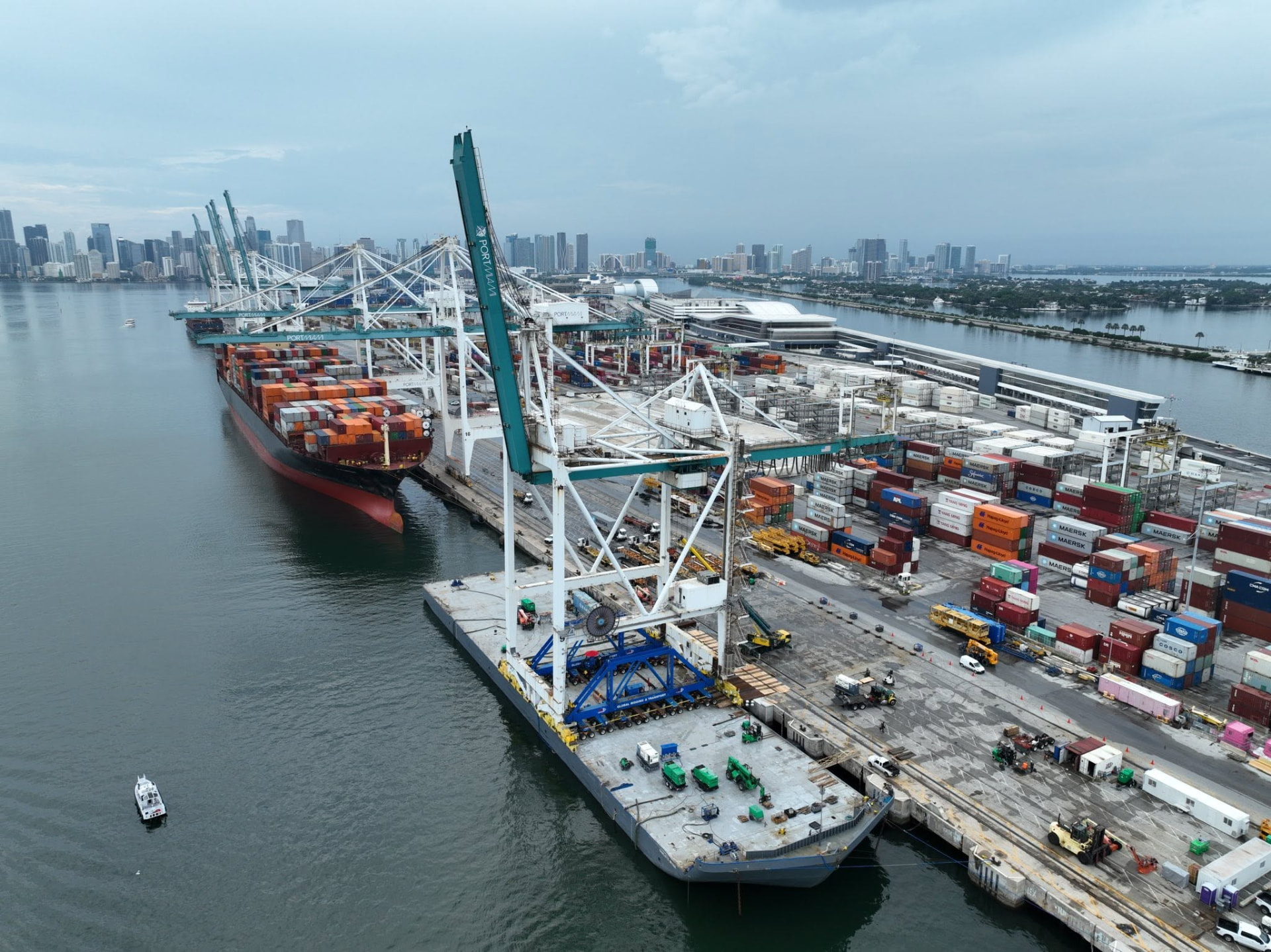

Aerial view of Crane 9 on the barge alongside the PortMiami wharfCrane 9 secured on the Charlotte Bridge barge with transport framesCrane 9 being loaded onto the barge at the wharfOverhead view of Crane 9 barge loading next to a container vessel
AUG 2025 – DEC 2025

Cranes 4-6 & 11-12 OEM Refurbishment and Repairs

This project addressed the replacement of Cranes 5 and 6 boom hinge pins, WS forestay pins, Operator Cabins Support Structure, Trolley Wheel alignment for Crane 6, WS Backstay Plates replacement, among others.

Progress100%

Operator cabin removed for support structure replacementOperator cabin staged on the wharf with the Miami skyline behindNew WS forestay pin installedWorn WS forestay pins removed from serviceRefurbished forestay pin connection after repaintingScaffolding erected on the crane boom for repair works
